Every day a hotel room is out of service for renovation is lost revenue. Prefabricated shower systems — combining solid surface wall panels, shower base, and accessories into a pre-engineered kit — can reduce bathroom renovation time from 2–3 weeks per room to 5–8 days. That's 40–50% less downtime, which directly impacts the renovation ROI.

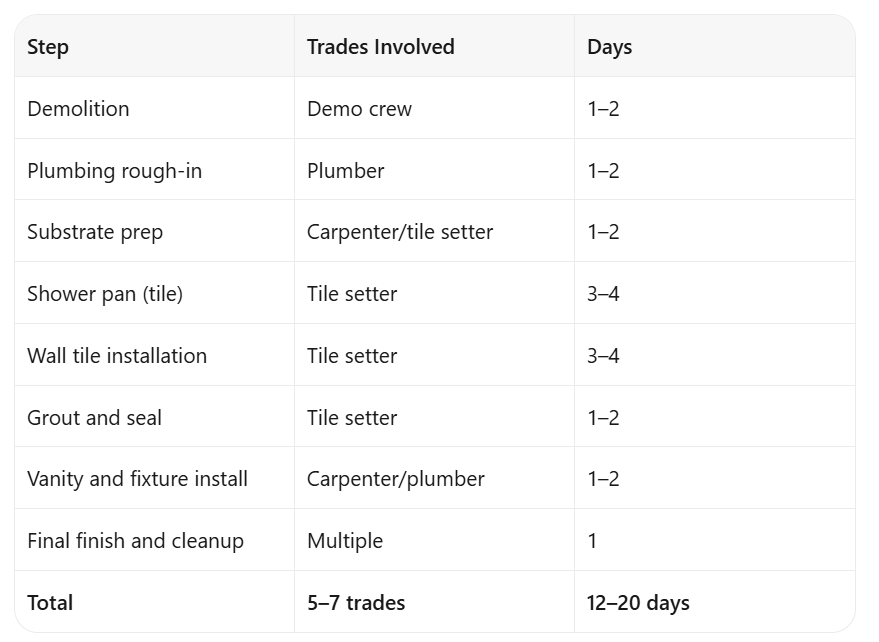

A conventional hotel bathroom renovation follows this sequence:

The problem isn't any single step — it's the sequential nature and the dependencies between trades. The tile setter can't start until the plumber finishes. The grout can't go in until the tile is set. Each step creates a handoff delay.

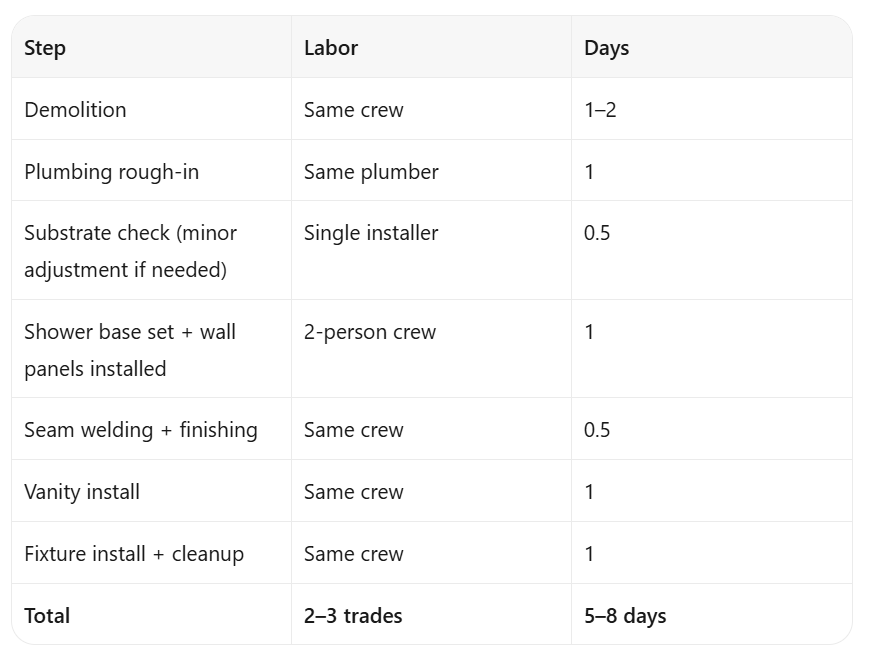

A typical hotel prefabricated shower system includes:
Everything comes in a single box per bathroom. The installer doesn't need to measure, cut, or assemble multi-layer systems. They install pre-sized components with gap-free alignment.

Time savings: 40–60% reduction in construction days per room. Multiply by 200 rooms and the project timeline shifts from 8–12 months to 4–6 months.
Fewer trades. A tile shower requires a tile setter, a grout finisher, and sometimes a waterproofing specialist. Prefab solid surface systems are installed by one skilled crew — typically a solid surface fabricator or a trained general contractor.
No wet-time delays. Tile requires drying/cure time for mortar (24–48 hrs), grout (24 hrs), and sealant (24 hrs). That's 3–6 days of waiting per bathroom that don't exist with solid surface installation.
Single-point responsibility. If a tile shower leaks, the finger-pointing starts: was it the liner, the mortar bed, the grout, or the drain seal? With a prefab system, there's one installer and one material — liability is clear.

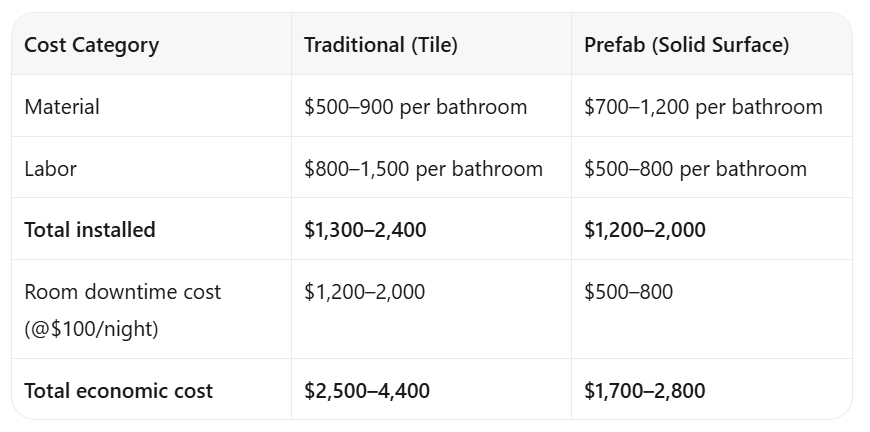

The prefab system costs more in materials but less in labor and downtime. For a 200-room hotel, the total savings in economic cost (material + labor + lost revenue) is $160,000–320,000.
A SpringHill Suites property in the Southeast U.S. renovated 150 bathrooms using a prefabricated solid surface shower system.
Traditional approach: 14 days per room, 3 trades, estimated 10-month project timeline, 60 rooms out of service at any time.
Prefab approach: 6 days per room, 2 installers, 5-month project timeline, 40 rooms out of service at any time.
Results:
2,100/bathroom vs. budgeted 3,400Q: Can prefab systems be used for historic hotels or non-standard layouts? A: Yes, but customization adds lead time. Custom-sized panels and bases can be fabricated to fit within ⅛" tolerance. Ordering custom prefab kits typically adds 2–3 weeks to lead time.
Q: What's the minimum order for a prefab system? A: For standard sizes, most fabricators offer prefab kits for orders of 25+ bathrooms. Below that, the fabrication per-unit cost increases. Guangdong Wiselink Ltd. can coordinate with partner fabricators for prefab program pricing on orders of 100+ bathrooms.
Q: Do prefab systems limit design options? A: Less than you'd think. While the system is standardized, color and finish options remain flexible. Wall panels can be custom-colored, and the base texture can be adjusted. What you lose is tile pattern variety; what you gain is installation speed and leak reliability.
